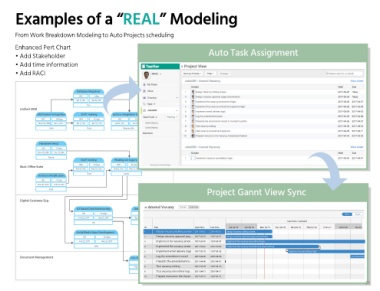

Page 25 - EA & ISTM for Enterprise
P. 25
Examples of a “REAL” Modeling
From Work Breakdown Modeling to Auto Projects scheduling
Enhanced Pert Chart
Auto Task Assignment
• Add Stakeholder
• Add time information
• Add RACI
Database Migration
Migration Roadmap 002 6 days
Jan 4, 2017 Jan 10, 2017
Tim
Unified CRM
CRM System Integration Staff Training System Integration Testing
001 34 days 004 16 days 005 3 days
Nov 30, 2016 Jan 3, 2017 Jan 4, 2017 Jan 20, 2017 Jan 11, 2017 Jan 14, 2017
John Terry Responsible
Hardware Setup
006 11 days
Nov 30, 2016 Dec 11, 2016
Morris
Staff Training Phasing out Legacy
008 17 days 009 10 days
Back-Office Suite
Feb 11, 2017 Feb 28, 2017 Feb 11, 2017 Feb 21, 2017
Terry Jamie
Software Modification
007 72 days
Nov 30, 2016 Feb 10, 2017
John
Project Gannt View Sync
Digital Customer Exp.
Amend Vacany Task List Gantt Chart
IoT-Based Data Warehousing Automated Data Analysis
010 50 days 012 16 days Week Month
Feb 22, 2017 Apr 13, 2017 Apr 14, 2017 Apr 30, 2017
Sun 03-06 - Sat 04-01
Tim Jamie
ID Title Start Time End Time Sat 03-25 Sun 03-26 Mon 03-27 Tues 03-28 Wed 03-29 Thur 03-30 Fri 03-31 Sat 04-01 Sun 04-0
Social Media Apps Development 1 Design Vacancy Editing screen 2017-03-25 2017-03-27 Design Vacancy Editing screen
010 29 days 2 Design vacancy approval pag... 2017-03-25 2017-03-27 Design vacancy approval page (amendment)
Feb 22, 2017 Mar 23, 2017 3 Implement the vacancy amen... 2017-03-25 2017-04-07 Implement the vacancy amendment logic
John 4 Implement the vacancy amen... 2017-03-25 2017-03-30 Implement the vacancy amendement approval logic
5 Implement email delivery logic 2017-03-29 2017-04-03 Implement email delivery logic
Log the amendment record
6
Document Management Doc. Mmt. Backup Server Setup 2017-04-03 2017-04-06 Log the amend
7 Presents the amendement re... 2017-04-06 2017-04-07
013 20 days
Test vacancy editing
Apr 14, 2017 8 May 4, 2017 2017-04-07 2017-04-10
9 Morris Test vacancy amendment ap... 2017-04-11 2017-04-11
10 Prepare manual on the Vacan... 2017-04-22 2017-04-22
25
